Since surgical services generate considerable revenue, its growth is frequently listed among the strategic objectives for many hospitals. Deaconess Hospital in Evansville, Indiana, USA, had experienced surgical growth of 7 to 10 percent for two years and expected this trend to continue due to the introduction of bariatric surgery and emphasis on neurosurgery and the cardiovascular product line. Hospital leadership sought to accommodate the continued growth without adding new rooms and resources.

The hospital started a Lean Six Sigma program in 2004, and was confident a project focused on surgery patient throughput would help increase efficiencies in the operating room. Lean value stream mapping helped the project team to validate areas with the greatest potential, while Work-Out sessions allowed frontline staff to identify the best improvement strategies. Data analysis revealed significant potential for reducing cancellations and delays on the day of surgery. As a result of the project, the hospital maximized surgery volume, raised customer (physician and patient) satisfaction and increased annual net revenues by $1 million.

Defining the Problem

Surgery management at Deaconess Hospital believed it could effectively increase efficiency and throughput to ensure that existing surgery rooms and resources could accommodate continued growth. The goal was to maximize operating room (OR) capacity and resources without jeopardizing physician, staff or patient satisfaction.

A team charter was written and approved by administration. The project charter included:

Project Scope – All processes beginning with the scheduling of the surgery and ending with the room ready for the next surgery.

Problem Statement – Based on customer feedback, opportunities exist to improve OR throughput. By optimizing current processes, the OR will reduce delays, increase customer satisfaction and facilitate growth.

Business Case – The surgery department had experienced 7 to 10 percent growth for the last two years. This trend was expected to grow. The surgery management staff was challenged with maximizing the number of surgery cases completed daily with the same number of surgery rooms and resources.

Operational Definition – Cancellations day of surgery due to tests: All surgery patients arriving the day of surgery whose surgery was scheduled more than one day in advance. Tests include all laboratory testing, EKG and X-rays that can be done prior to the day of surgery.

Initial Goal – Improve surgery throughput to accommodate a 7 percent annual growth

Team Members – The team consisted of the four Green Belts, surgery managers, same day surgery and holding room manager, laboratory staff, surgery staff, surgeons and anesthesiologists. The vice president of operations served as project Champion and the director of surgery served as project sponsor.

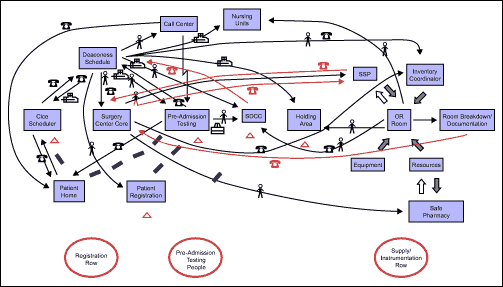

The project charter established direction for the team and parameters for the process. A value stream map (Figure 1) depicted the current process and pointed the team to three potential focus areas – patient registration process, pre-admission process, and supply and instrumentation flow.

Figure 1: Surgery Throughput Value Stream Map
Figure 1: Surgery Throughput Value Stream Map

Measurement and Analysis of the Data

A high-level process map for the day of surgery was created and broken into four sub-processes – patient registration, same-day patient preparation, holding room and operating room (Figure 2). While analyzing the data by sub-process, the Green Belts discovered that only 14 percent of patients were ready for their surgery when they arrived in the holding room.

Figure 2: High-Level Process Map
Figure 2: High-Level Process Map

The team brainstormed reasons for delays and collected data to identify the most significant factors. The primary cause turned out to be lack of required diagnostic testing prior to the day of surgery. Upon further analysis, the team found an overall surgery cancellation rate of 13.9 percent, nearly double the national benchmark of 7 to 8 percent. One-fourth occurred the day of surgery, resulting in lost revenue and reduced physician and patient satisfaction. The No. 1 reason for cancellations on the day of surgery was determined to be test results, 28 percent.

Based on these findings, project goals were redefined as:

  • A 25 percent reduction in cancellations on the day of surgery due to tests.
  • Twenty-five percent of all patient test results to be completed 48 hours prior to surgery.
  • Location of pre-admission testing required for surgery identified 72 hours in advance of surgery for 75 percent of patients.

Process Improvement Using Work-Out

The project team planned and conducted two Work-out sessions with frontline staff and developed the following improvement strategies:

  • Integrated process for determining surgery readiness regarding tests 72 hours in advance.
  • Development of a shared database file for process owners to evaluate and follow up on patient preparedness 48 hours in advance.
  • Contingency plan for flexing staff to match workload to assess patient readiness.

A six-week pilot of the new process was completed, staff was trained, process documentation was completed, and necessary process adjustments were made. To sustain improvements, the team developed a plan that included control charts (Figure 3) for the process owner to monitor the process and outcomes.

The control charts are provided monthly to the director of surgery, surgery core care team and health system quality council in order to hold the process owners accountable for ongoing results.

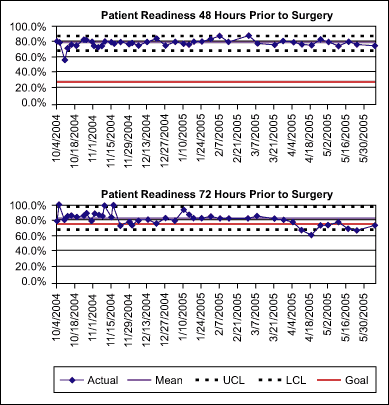

Figure 3: Pre-Op Readiness - 48 and 72 Hours
Figure 3: Pre-Op Readiness – 48 and 72 Hours

Achieving and Maintaining Results

Results following the pilot (July 2004) demonstrated a significant improvement in patient readiness:

  • 80 percent reduction in cancellations day of surgery due to tests.
  • 44 percent of test results complete 48 hours in advance.
  • Preadmission testing location identified for 77 percent of surgery patients.

Additional benefits were increased awareness of patient preparedness regarding tests 72 hours in advance by all participants in the process and a team approach to patient readiness. Also, the overall cancellation rate fell from 13.9 percent to 8 percent as a result of the project. The financial impact also was a positive, with an additional $1 million a year in revenue due to avoided cancellations.

Perhaps most importantly, the results have been sustained over time. The project ended in July 2004, and as of July 2005, cancellations day of surgery due to tests were less than 1 percent. The overall surgery cancellation rate remains below 8 percent.

Translation Opportunity

Six Sigma emphasizes the importance of project translation to similar processes and areas within an organization. The project team presented its solutions and outcomes to physicians and staff who might benefit from the new process. A team working with the cardiac catheterization lab to improve first case on-time starts identified the potential for replicating the patient preadmission process. The cath lab consolidated its pre-readiness function with the surgery process. After only one month, the number of patients contacted prior to the day of cardiac catheterization improved from 60 percent to 72.2 percent.

As demonstrated in this project, Six Sigma statistical analysis tools paired with the power of Work-out provide a proven method for achieving measurable, positive results that are sustained over time.
